Gujarat Real-Estate Bulletin
Gujrera
Guide· 6 Jun 2026

How to Submit a Bank Change Request (BCR) on GujRERA Portal — RA1+RA2 and RA3+RA4 Guide

By Gujarat Information

GujRERA Bank Change Request (BCR) is the formal process for a registered project promoter to apply for a change to the project's RERA Bank Account. Under Section 37 of the RERA Act 2016 and the Gujarat RERA Bank Account Directions, 2018, any change to a project's designated RERA Bank Account requires prior approval from the GujRERA Authority — an unauthorized change can result in regulatory action.

The BCR process is a two-stage procedure on the GujRERA 2.0 portal:

Stage Forms Purpose
Stage 1 RA1 + RA2 Apply for permission to change bank account; declare existing account closure details
Stage 2 RA3 + RA4 Confirm transfer of funds to new account after Stage 1 approval

Critical: Both stages must be completed. Promoters are barred from filing QPR while Stage 1 is pending, and again after Stage 1 approval until Stage 2 is submitted and approved. Avoid submitting BCR near QPR quarter-ending dates.

Who Must File a BCR

A Bank Change Request is required for:

Changing the RERA project bank account without prior GujRERA Authority approval makes the promoter liable for regulatory action as determined by the Authority.

STAGE 1 — RA1 + RA2 Application

Step 1: Log In and Open the Approved Project

Log in to the GujRERA portal with your Promoter credentials. On your Dashboard, click on the Approved Project for which you need to change the bank account.

GujRERA Promoter Dashboard showing Approved Project tile with project name, registration number and dashboard summary tiles
Click the approved project on your dashboard — the project must have an active RERA registration

Step 2: Click Apply → Bank Change Request

On the Project Dashboard, click the orange Apply flag on the right side of the screen. A collapsible menu opens. Select Bank Change Request from the list.

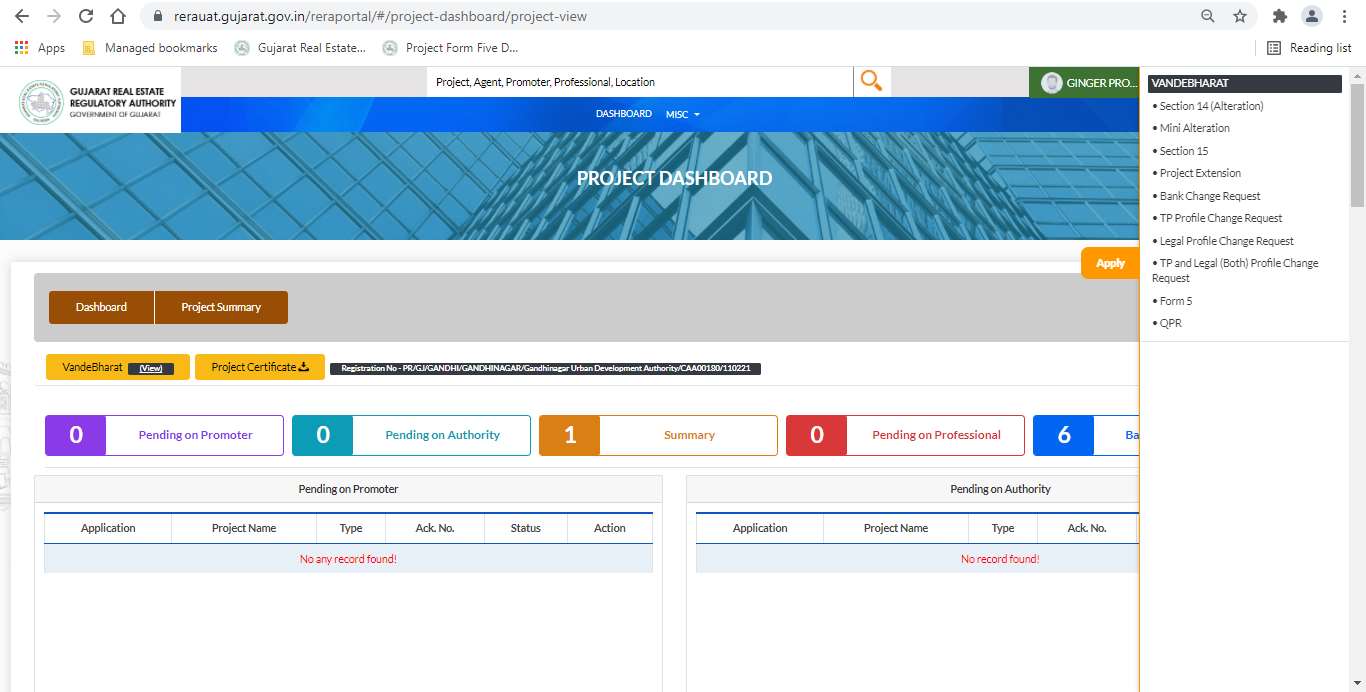

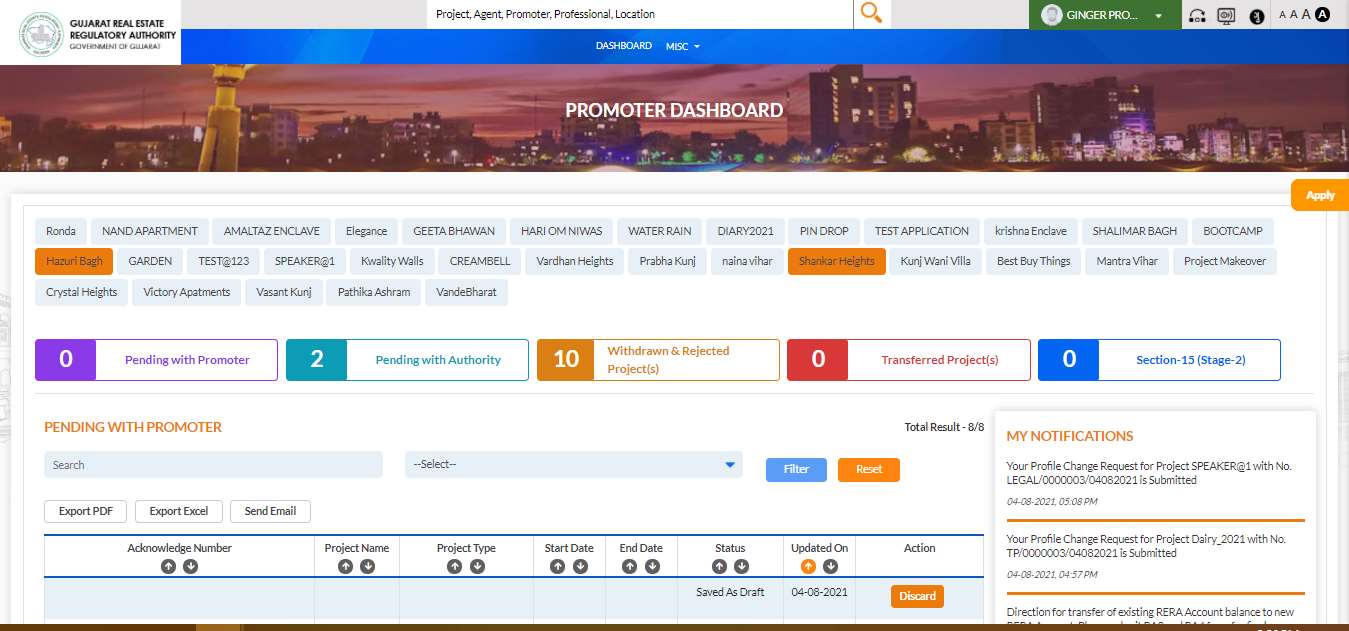

GujRERA Project Dashboard Apply flag dropdown showing Bank Change Request option along with other application types
Select "Bank Change Request" from the Apply dropdown — this opens the BCR RA1+RA2 application form

Step 3: Review the BCR Form and QPR Deadline Notice

The BCR RA1+RA2 form opens. At the top of the form, a notice displays the next applicable QPR filing deadline.

Important: Once you submit the BCR application, you will be systemically blocked from filing the applicable QPR until the BCR is either approved or rejected by the Authority. The QPR deadline shown in the declaration is your reminder — filing the BCR close to a QPR deadline risks putting you in default on the QPR. Plan accordingly.

GujRERA BCR RA1+RA2 form showing QPR deadline notice, project and promoter details at the top of the Bank Change Request form
Note the next QPR deadline displayed — submitting BCR near this date will block your QPR filing until BCR is resolved

Step 4: Fill RA1 + RA2 Bank Details

The form has two sections — RA1 (existing bank account details) and RA2 (new bank account request):

RA1 — Existing Bank Account Details:

Bank details are auto-fetched from your original Form-A (project registration application) for the first BCR submission. Verify these are correct:

RA2 — New Bank Account Request:

GujRERA BCR RA1+RA2 form showing existing bank account details auto-fetched from Form-A, reason for bank change dropdown, and upload fields for RA2 certificate and new bank passbook
Auto-fetched bank details from Form-A are shown for the first BCR — verify they match your registered account before proceeding

Scroll down to the Declaration section and tick all Declaration checkboxes, then click Submit to proceed to the preview step.

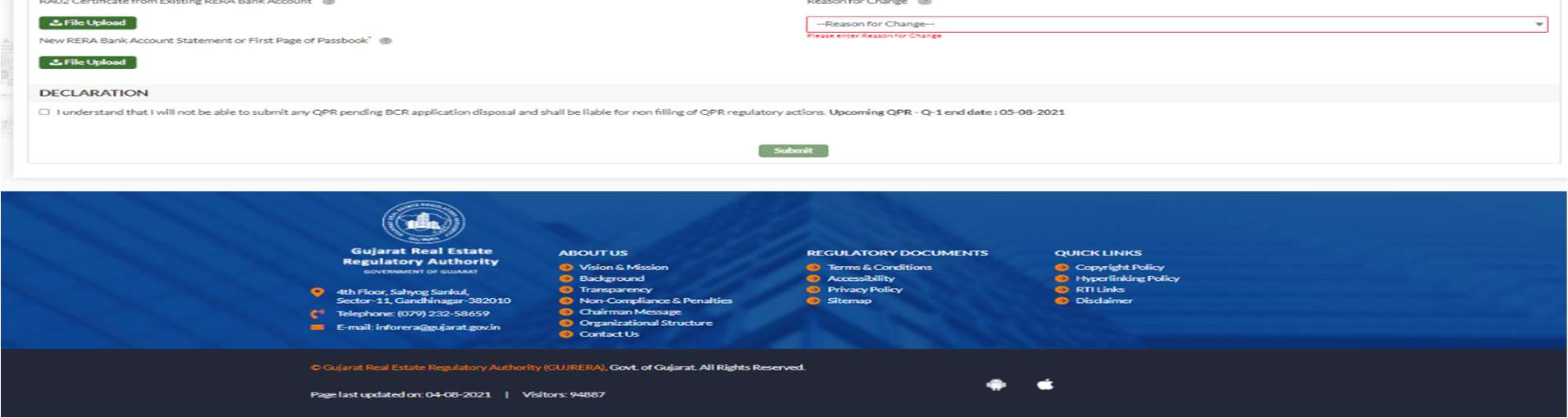

GujRERA BCR RA1+RA2 form Declaration checkboxes and Submit button at the bottom of the form
All declaration checkboxes must be ticked before the Submit button activates

Step 5: Preview Application and Pay

After clicking Submit, the Preview and Payment screen appears.

Click Preview Application to generate and review the complete PDF of the filled RA1+RA2 form. Click Print to download it.

When satisfied, tick all declaration checkboxes and click Agree and Pay.

Note: The Agree and Pay button is enabled only after all checkboxes are ticked.

Once on the payment screen: "PLEASE DO NOT PRESS BACK OR REFRESH FROM THIS POINT ONWARDS."

Payment Details shown:

Complete payment on the SBI ePay gateway via Net Banking, Debit/Credit Card, or BHIM UPI. For Corporate Net Banking, the Maker-Checker approval must be completed within 20 minutes.

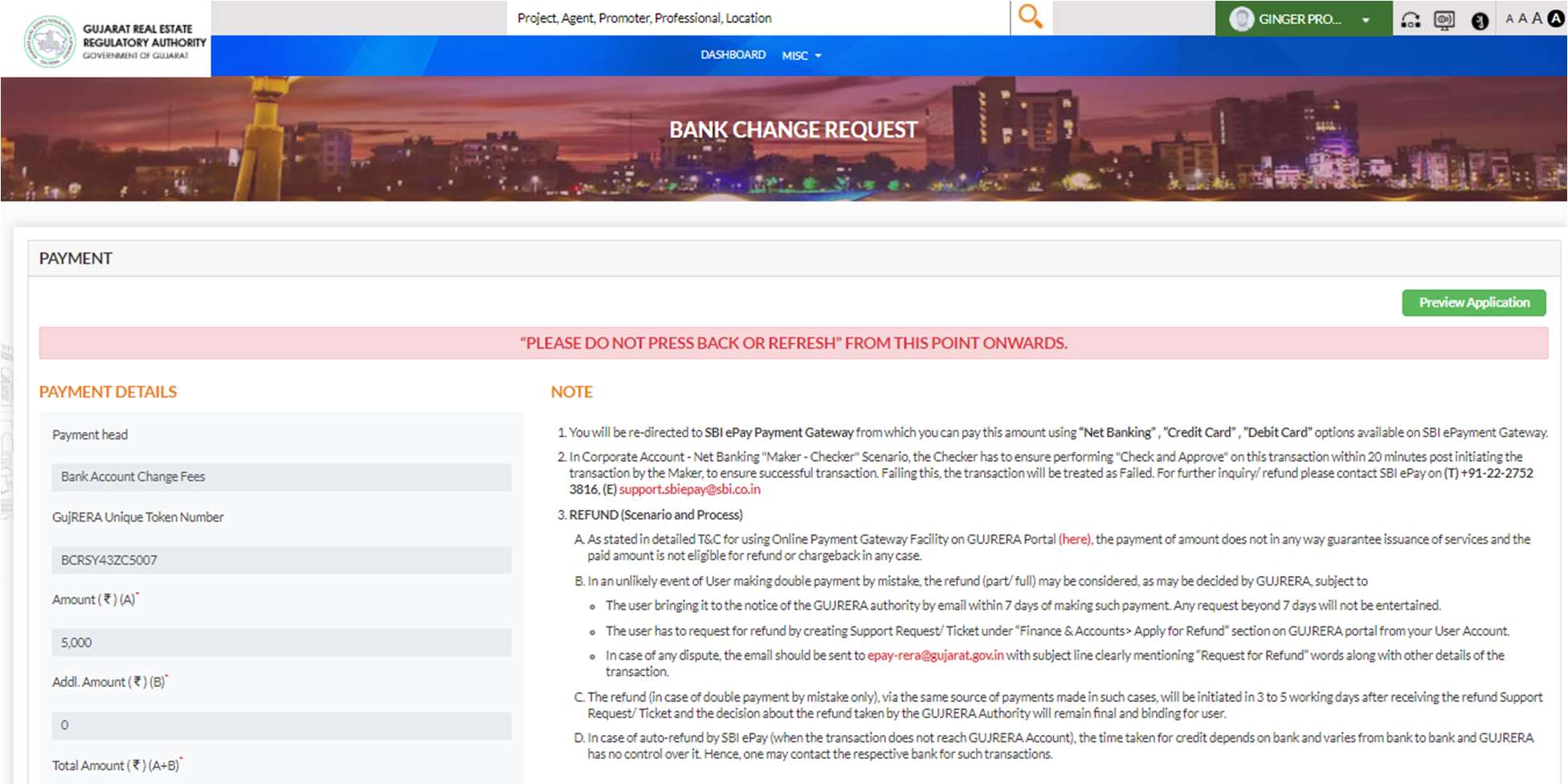

GujRERA BCR RA1+RA2 Preview Application button, declaration checkboxes and Agree and Pay button with payment details showing Token Number, Amount A and B
Preview and print the application first, then tick checkboxes and click Agree and Pay — the button stays disabled until all boxes are ticked

Step 6: Acknowledgement and Confirmation

After successful payment, the portal generates a unique BCR Acknowledgement Number. The submission screen shows:

Click Print Receipt to download the SBI ePay payment receipt.

An Email and SMS confirmation is sent to your registered contact details upon successful submission of RA1+RA2.

The BCR application is now visible on your Project Dashboard BCR section.

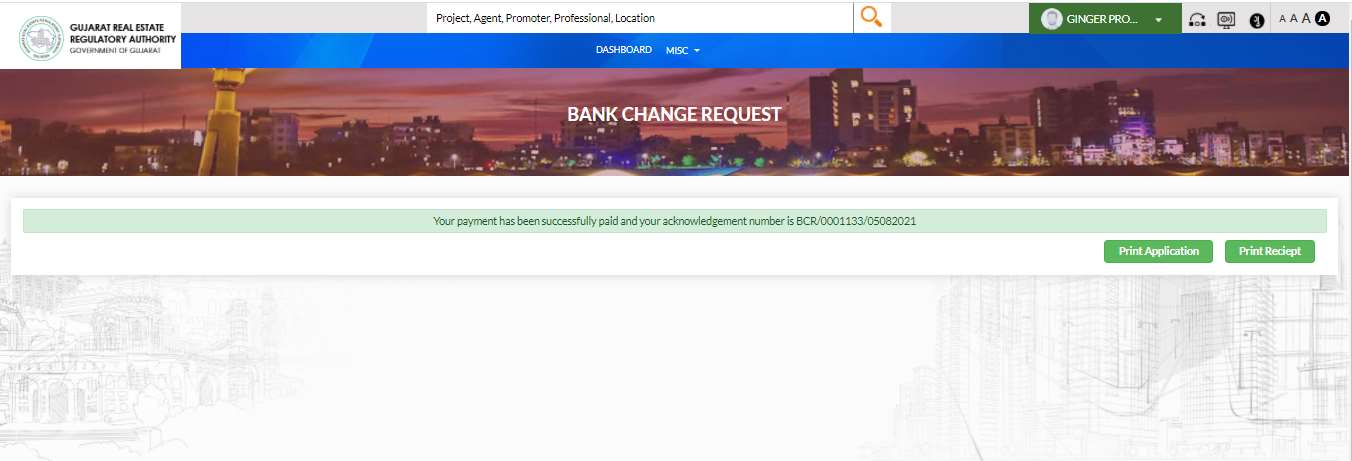

GujRERA BCR RA1+RA2 Acknowledgement screen showing Acknowledgement Number, project details, Print Application and Print Receipt buttons
Save the Acknowledgement Number and the payment receipt — you will need these to track the BCR status and for Stage 2

Until Authority approves RA1+RA2:

  • You cannot submit RA3+RA4
  • You cannot file the applicable QPR

STAGE 2 — RA3 + RA4 (After RA1+RA2 Approval)

Once the GujRERA Authority approves your RA1+RA2 application, you will receive an Email and SMS notification. You can then proceed to Stage 2.

After RA1+RA2 approval: You are again blocked from filing the applicable quarterly QPR until RA3+RA4 are both submitted and approved. It is your sole responsibility to obtain RA3 and RA4 from your bank and submit them promptly. Delays will result in QPR default.

Step 7: Log In and Navigate to the Approved BCR

Log in and click on the same project where RA1+RA2 was approved. On the Project Dashboard, find the BCR section showing your application with status RA1+RA2 Approved.

GujRERA Project Dashboard BCR section showing approved RA1+RA2 application with Pending Authority status and the initiate RA3+RA4 option
The BCR section shows your RA1+RA2 approved — look for the View button to open the Stage 2 form

Click the View button against the approved BCR application.

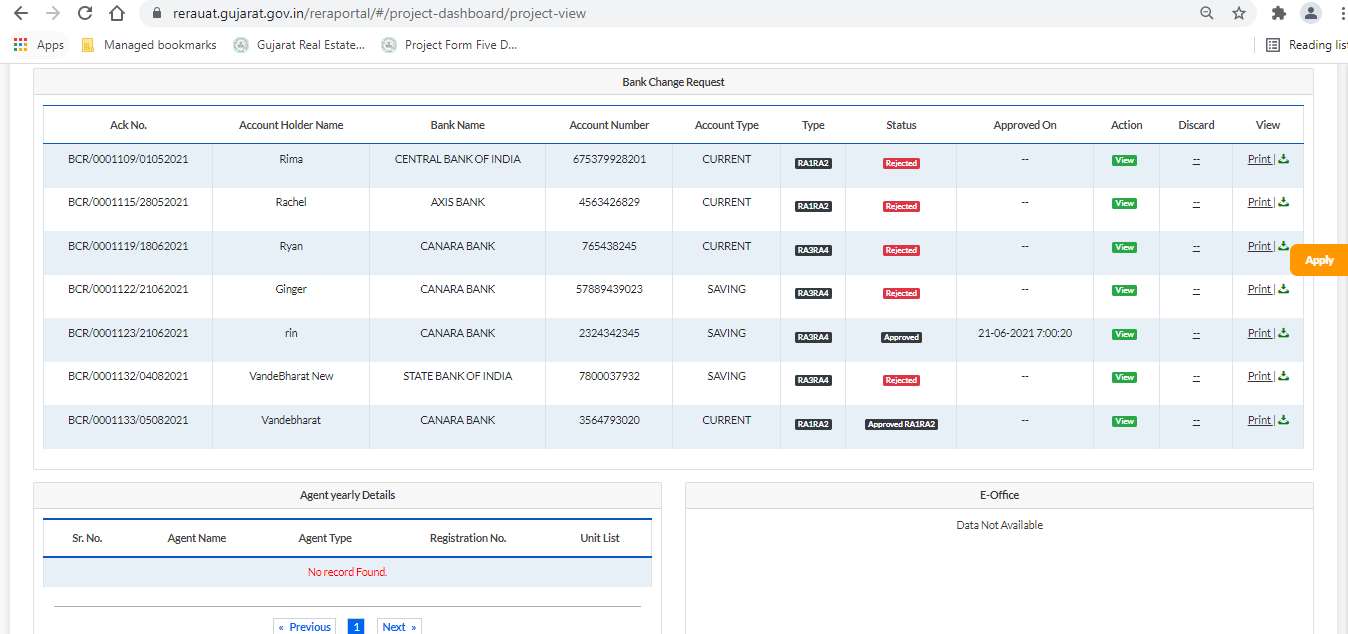

GujRERA BCR application view showing approved RA1+RA2 in read-only mode with View button and RA3+RA4 section now open for input
Clicking View opens the BCR form — RA1+RA2 is read-only (approved), RA3+RA4 section is now open for filling

Step 8: Fill and Submit RA3 + RA4

The RA1+RA2 section is now read-only (cannot be changed). The RA3+RA4 section is open for input:

Click Submit.

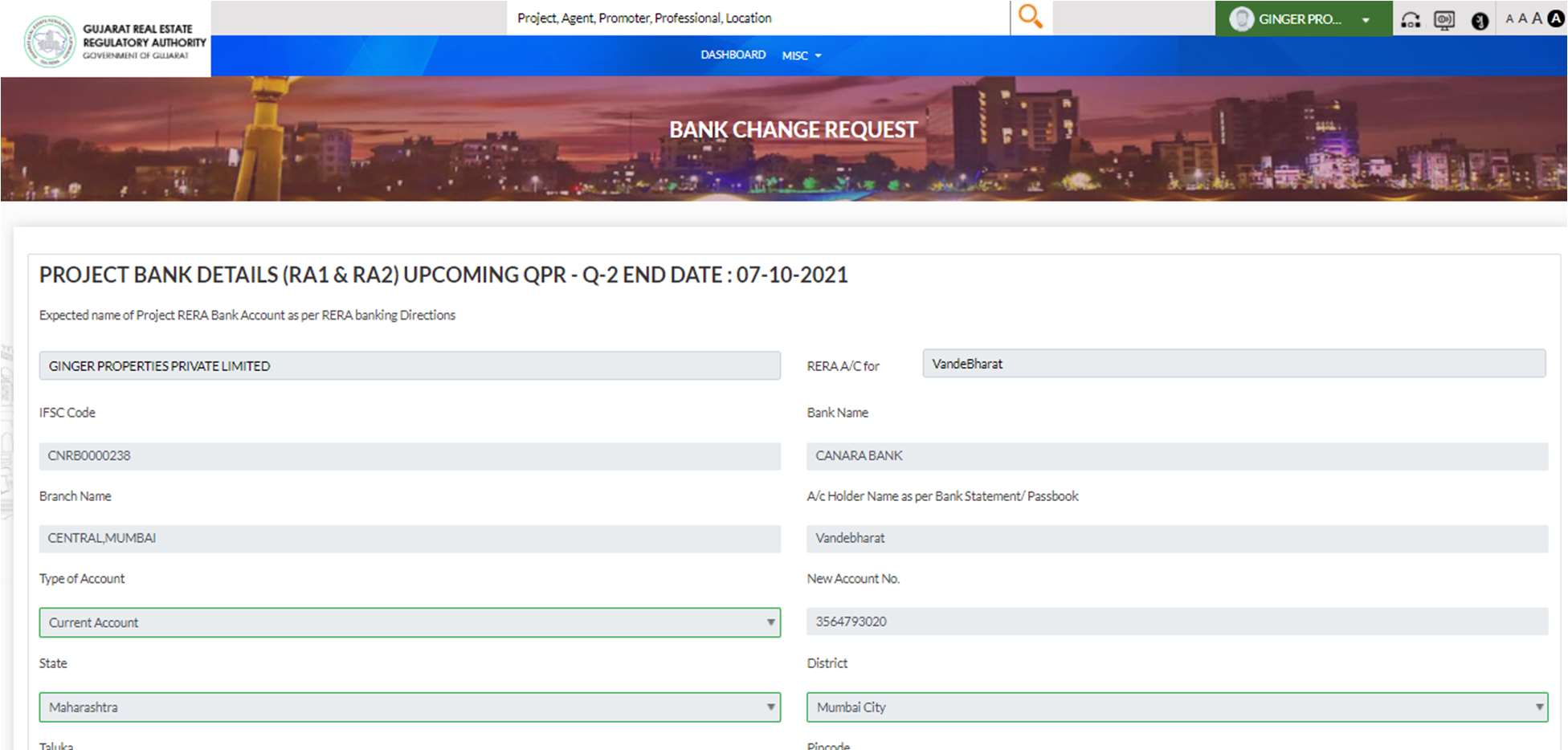

GujRERA BCR RA3+RA4 form showing read-only RA1+RA2 section above and open RA3+RA4 fields for Transferred Amount, Date, Upload RA3 and Upload RA4 with Submit button
The Transferred Amount in RA3 must exactly match the Closing Balance from RA2 — the portal enforces this validation

Step 9: Confirm Pending Scrutiny Status

After submitting RA3+RA4, the application status on the dashboard updates to "Pending Scrutiny".

An Email and SMS confirmation is sent on submission, and again when the Authority approves RA3+RA4.

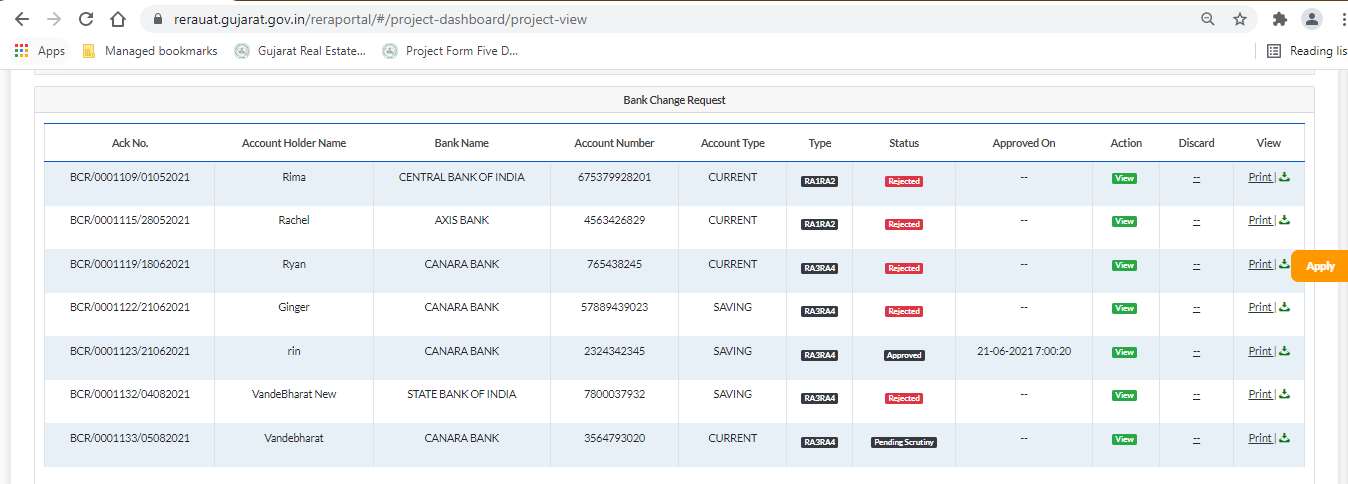

GujRERA BCR dashboard showing RA3+RA4 submitted with status Pending Scrutiny and project and bank account details
"Pending Scrutiny" means RA3+RA4 has been received by GujRERA and is under review — QPR filing remains blocked until approval

Once RA3+RA4 are approved by the Authority, the bank change is complete and QPR filing resumes normally.

BCR Timeline Summary

Stage Action QPR Status
Before BCR Normal QPR filing allowed
RA1+RA2 submitted Pending Authority QPR blocked
RA1+RA2 approved Proceed to Stage 2 QPR blocked
RA3+RA4 submitted Pending Scrutiny QPR blocked
RA3+RA4 approved BCR complete QPR filing resumes

Common Issues

RA3 Transferred Amount does not match RA2 Closing Balance: The portal enforces an exact match between the RA3 Transferred Amount and the RA2 Closing Balance as approved by the Authority. Obtain the correct figures from your bank before filling RA3+RA4.

QPR default due to BCR timing: If your BCR overlaps a QPR quarter-end date, you will be unable to file the QPR on time. Resolve the BCR well before the QPR deadline, or plan the BCR submission for after the QPR is filed. GujRERA advisory: "It is advisable to avoid submission of BCR around the Applicable Quarter Ending Dates."

RA1+RA2 payment deducted but Acknowledgement Number not generated: Note the GujRERA Unique Token Number from the payment screen. Raise a Support Ticket under Finance & Accounts → Apply for Refund, or email epay-rera@gujarat.gov.in with the token and SBI ePay transaction details.

Documents rejected by Authority — query raised on BCR: The rejection or query appears on your Project Dashboard. Click Action to view the query, address it, and re-upload the corrected documents. The BCR remains blocked until the query is resolved.

Cannot see RA3+RA4 fields after RA1+RA2 approval: Click the View button on the approved BCR row in the BCR section of the Project Dashboard. The RA3+RA4 input fields only appear through the View action on the approved RA1+RA2 record — they are not a separate application entry point.
